PROJECT DETAILS
Our Projects

ProjectDetails

PROJECT NAME: Proposed 3B + G + 12 + Roof Building
LOCATION : Al Jadaf
EMIRATE : Dubai, U.A.E.
PLOT NO : 3260927
CLIENT : Structure Real Estate Development
CONSULTANT : Castle Architectural Consultants
MAIN CONTRACTOR : Structure Advanced Building Contracting L.L.C.
ENABLING CONTRACTOR : High Deep Foundation Contracting L.L.C. (HDFC)
PROJECT CATEGORY : Deep Excavation
SECANT PILE SHORING SYSTEM

Proposed 3B + G + 12 + Roof Building

Plot No. 3260927, Al Jadaf, Dubai, U.A.E.

HIGH DEEP FOUNDATION CONTRACTING
PROJECT DETAILS
Our Projects

ProjectDetails

Proposed 3B + G + 12 + Roof Building
Location: Plot No. 3260927, Al Jadaf, Dubai, U.A.E.

  • Project Name: Proposed 3B + G + 12 + Roof Building
  • Location: Al Jadaf, Dubai (Plot No. 3260927)
  • Client: Structure Real Estate Development
  • Consultant: Castle Architectural Consultants
  • Main Contractor: Structure Advanced Building Contracting L.L.C.
  • Enabling Contractor: High Deep Foundation Contracting L.L.C. (HDFC)
  • Scope of Work (HDFC): Secant pile shoring system with 2 layers of struts and 3 layers of ground anchors; excavation to 16.0 m; excavation volume 24,000 m³.
  • Status: Completed / In Progress (choose one)
  • Key Services: Shoring, Anchoring, Deep Excavation, Temporary Works Design

PROJECT OVERVIEW
Our Projects

ProjectOverview

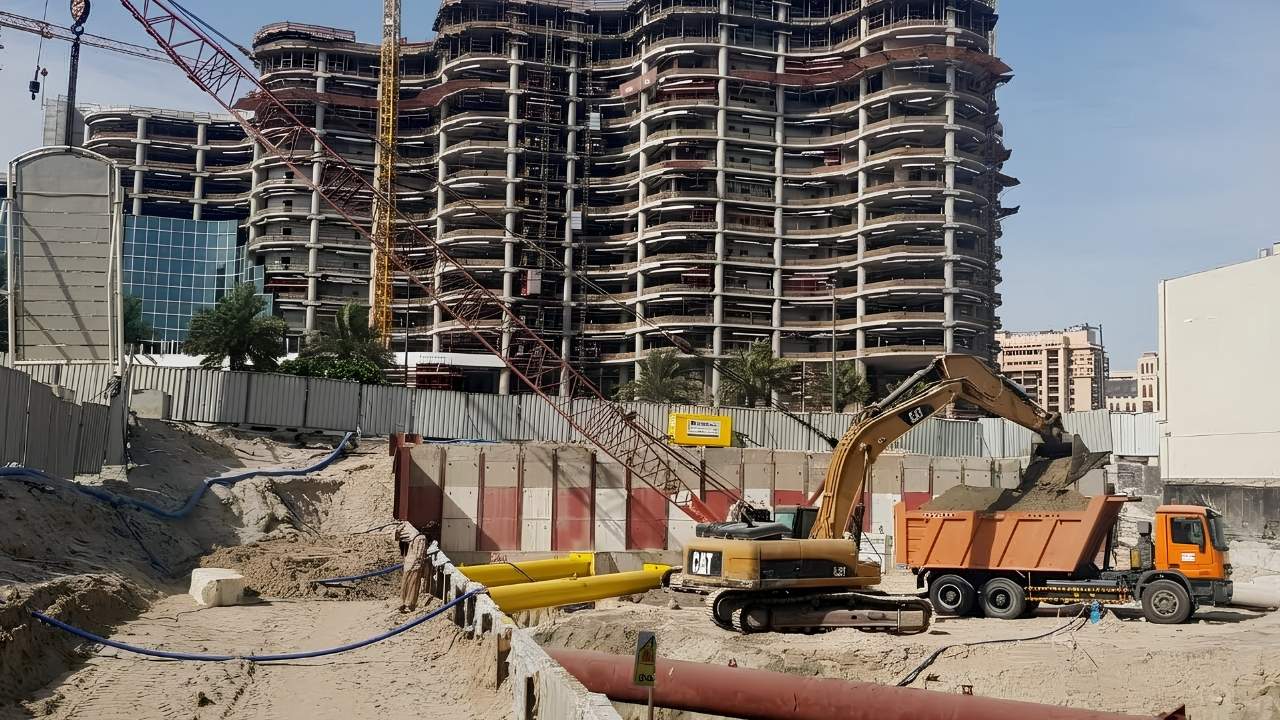

This development consists of a high-rise residential/commercial tower with three basements, ground floor, twelve floors, and a roof level, located in the densely developed Al Jadaf district of Dubai.
Due to the significant basement depth and challenging soil conditions, the project required a robust and well-engineered foundation and shoring system.

HDFC was appointed as the Enabling Works Contractor to design and execute the deep excavation support system, including the secant pile wall, multiple layers of anchors and struts, and controlled excavation operations.

A HIG DEEP INNOVATION
Scope of Work

Executed by High Deep

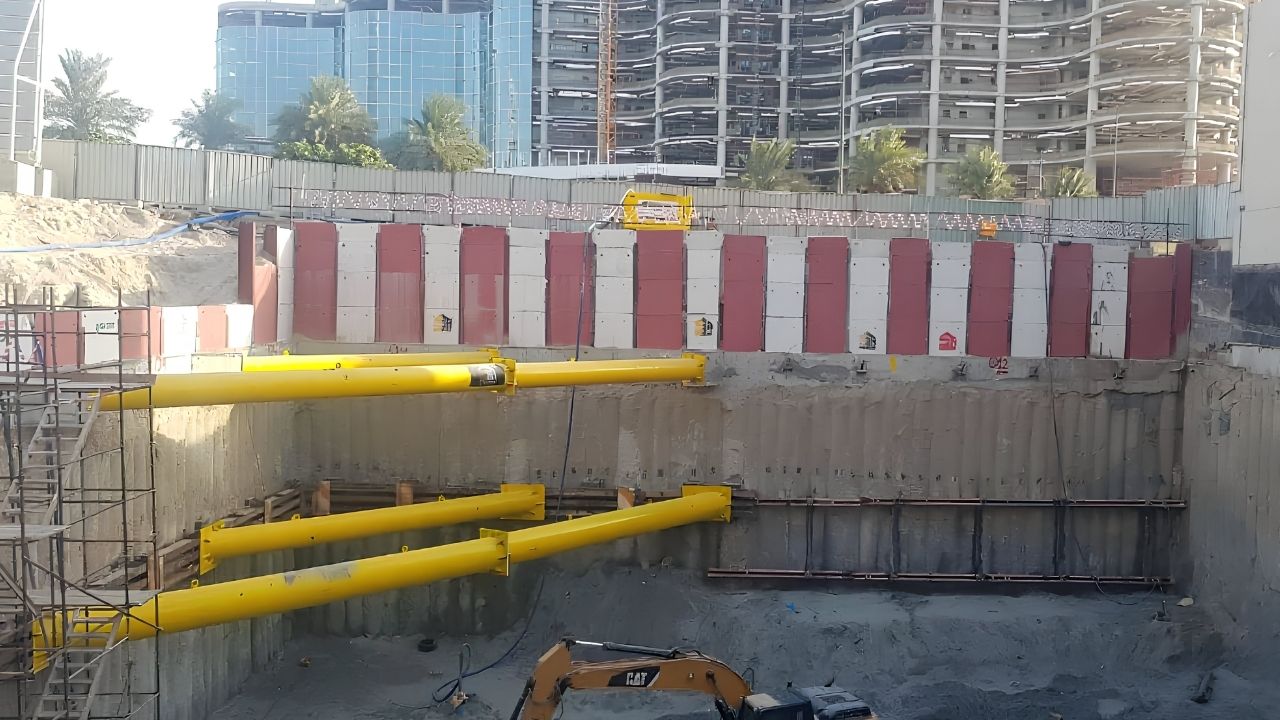

1️⃣Secant Pile Shoring System

HDFC constructed a secant pile wall system designed to retain soil and provide structural support during deep excavation.
The system was engineered to ensure:

  • High lateral stability
  • Controlled deflection
  • Improved groundwater resistance
  • Safe excavation to 16.0 m depth

This secant wall formed the primary boundary of the deep excavation area.

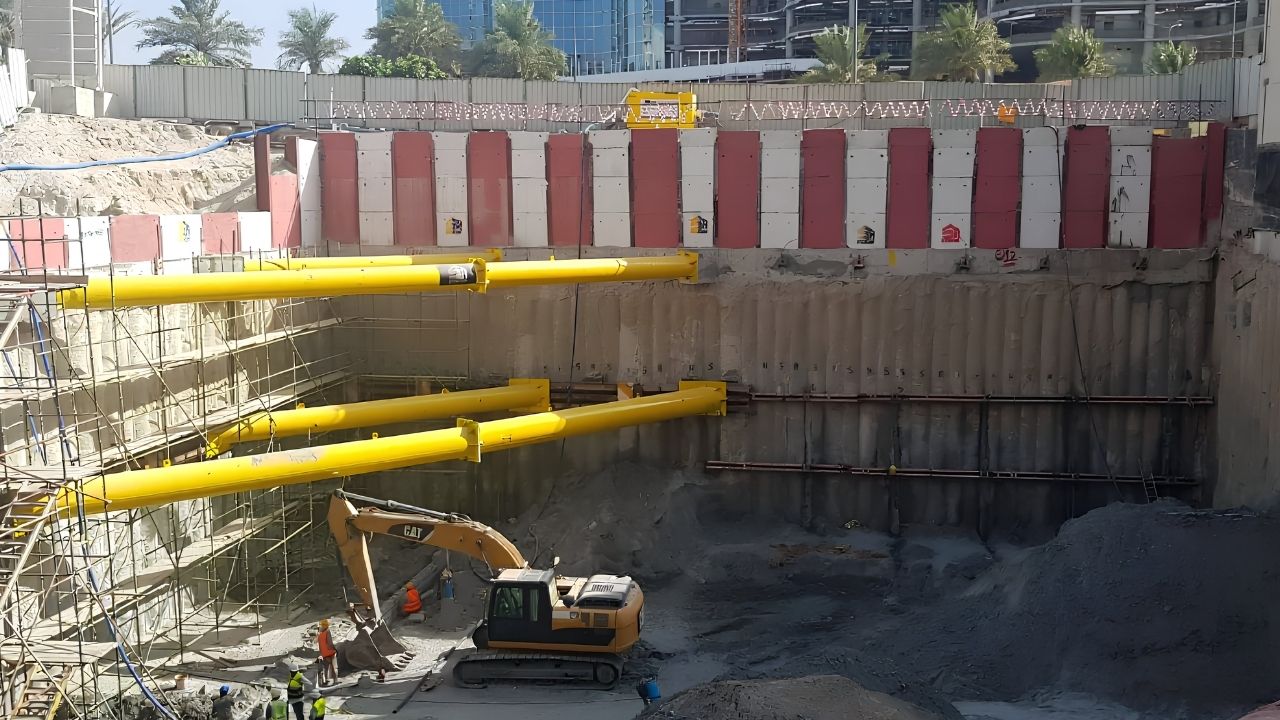

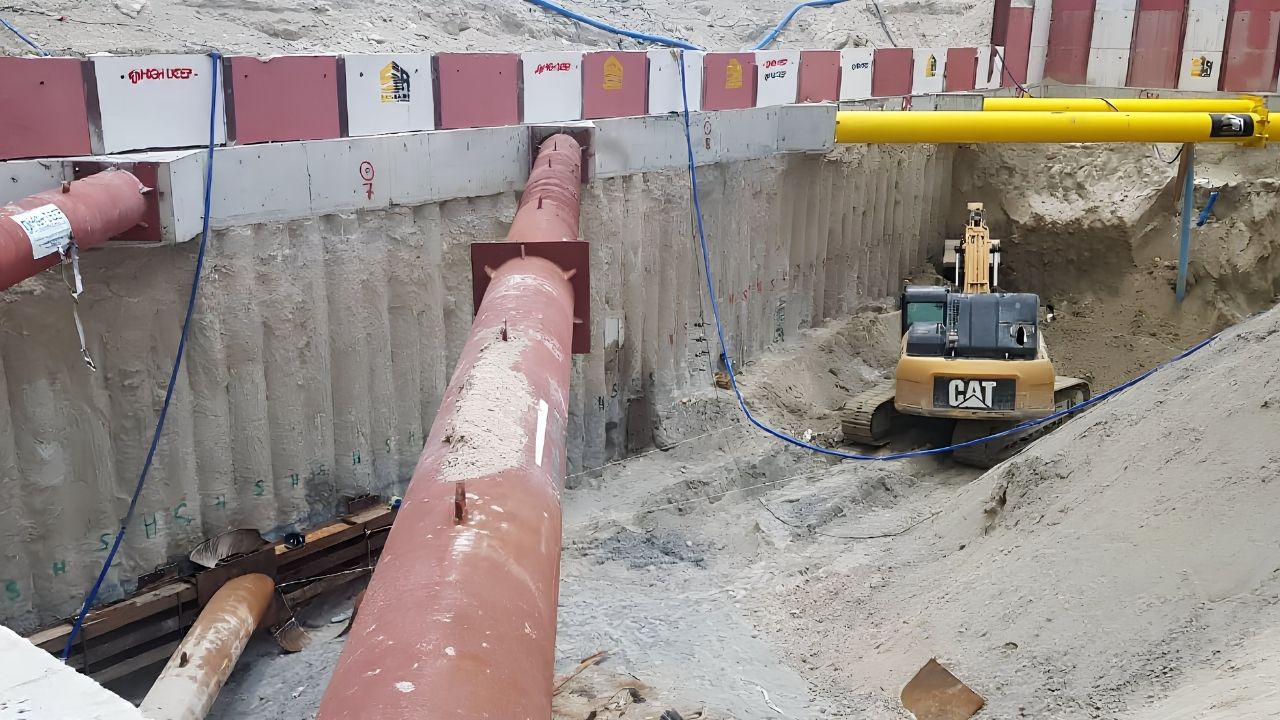

2️⃣ Two Layers of Steel Struts

To reinforce the retaining system, HDFC installed two levels of heavy-duty steel struts, strategically positioned to resist soil pressure and maintain stability throughout excavation.
These struts were designed to support the secant wall at critical stages and prevent deformation.

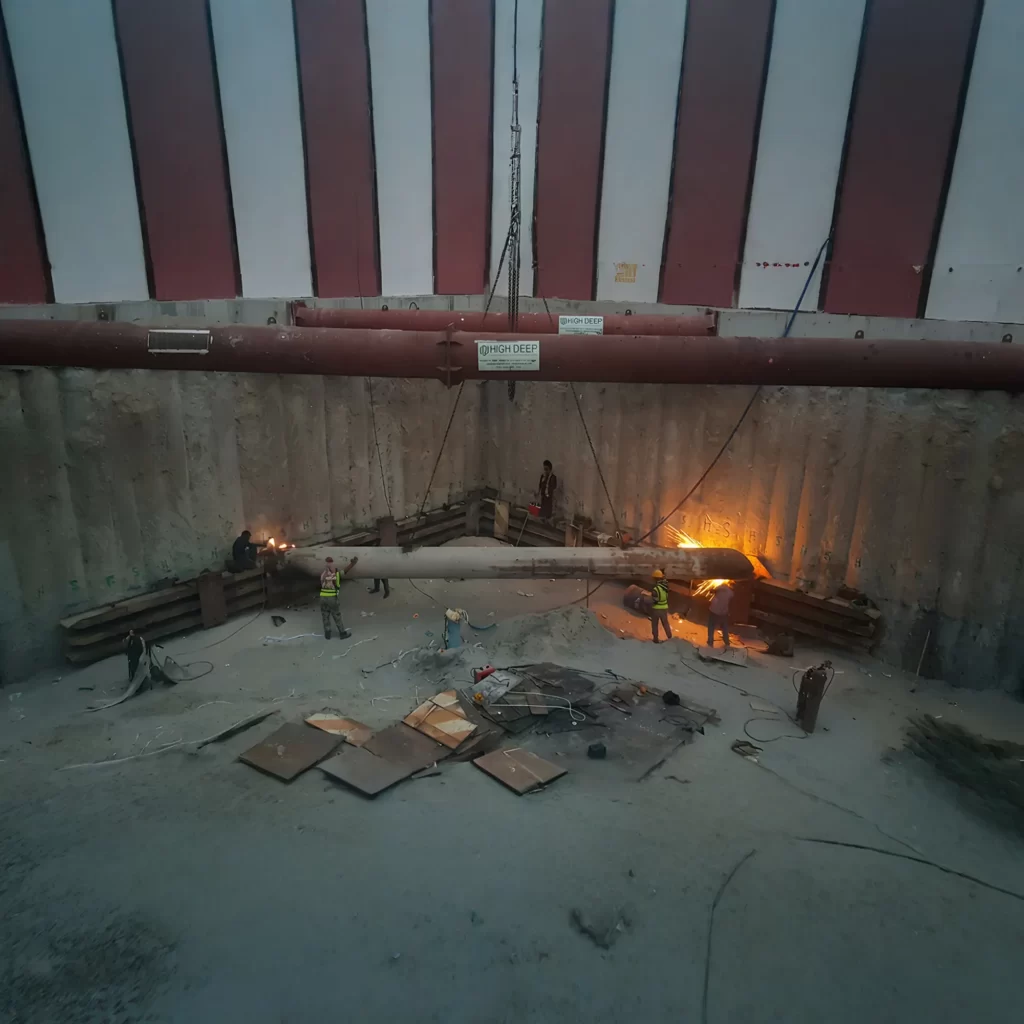

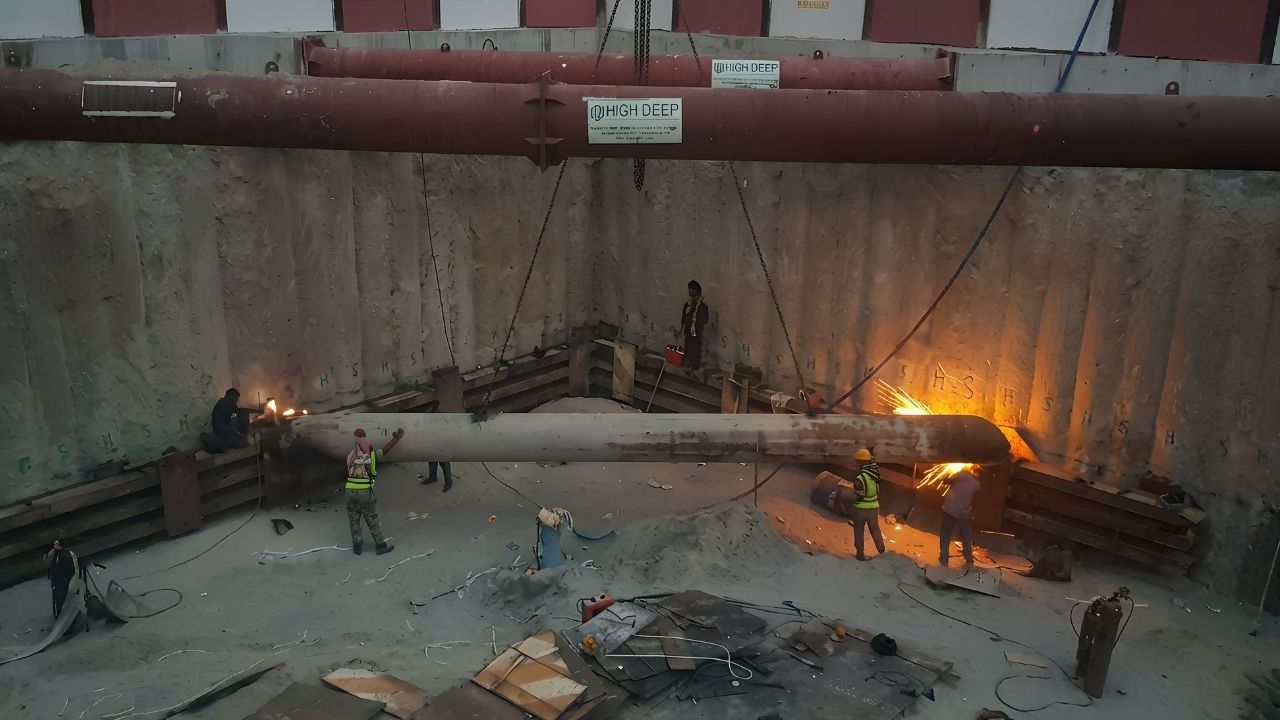

3️⃣ Three Layers of Ground Anchors

The project required three layers of pre-stressed ground anchors to further stabilize the excavation boundary.
These anchors enhanced the performance of the shoring system by providing:

  • Additional lateral restraint
  • Reduced wall movement
  • Improved overall excavation safety

Each anchor was tested and tensioned according to strict quality control procedures.

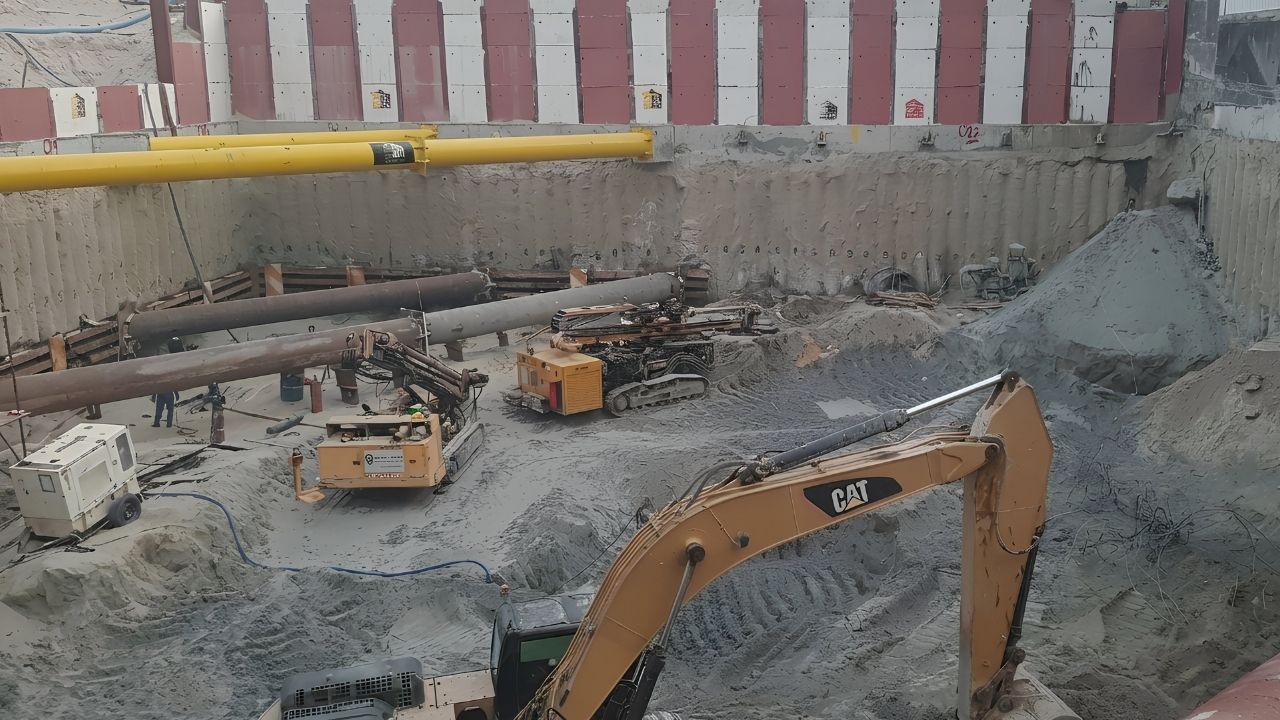

4️⃣ Excavation — 16.0 m Depth & 24,000 m³ Volume

HDFC executed the deep excavation, reaching a final depth of 16.0 meters and removing approximately 24,000 cubic meters of soil.
The excavation was carried out in controlled stages, based on engineering analysis and safety protocols.

Key considerations included:

    • Real-time wall deflection monitoring
    • De-watering coordination
    • Controlled excavation sequencing
    • EHS compliance to ensure zero incidents
🧪 Testing and Quality Assurance

🧪 Testing and Quality Assurance

To ensure the integrity of the shoring and anchoring system, HDFC conducted:

  • Anchor proof and performance testing
  • Strut load monitoring
  • Verticality and alignment checks for piles
  • Soil movement analysis
  • Daily inspections and safety audits

Detailed ITPs, QA/QC reports, and method statements were submitted throughout the project.

PROJECT DETAILS
Our Projects

ProjectHighlights

01

Advanced Shoring System

Successfully executed deep excavation and shoring works for a multi-basement high-rise structure.

02

High-Precision Piling Execution

Delivered precise piling and secant shoring systems using advanced drilling technology.

03

Efficient Deep Excavation Management

Maintained full compliance with consultant specifications and strict safety standards.

04

Strict Safety & Quality Compliance

Completed enabling works efficiently, ensuring a stable foundation for superstructure construction.

BENEFIT

🏆 Project Outcome

HDFC successfully delivered all enabling works within the scheduled timeline, without any safety incidents, and in full compliance with the consultant’s specifications.
The precise installation of secant piles, anchors, and steel struts ensured a highly stable excavation, enabling the main contractor to proceed confidently with raft and substructure construction.

The project stands as a strong showcase of HDFC’s ability to manage deep, complex, and high-risk excavations using advanced engineering solutions.
